←Back to portfolio

ERP ADVISORY SERIES

ERP Implementation Journey – 12 Steps to Success

A practical advisory series for organizations that want to select, prepare and implement the right ERP system. It turns the implementation journey into clear business stages that reduce risk and keep technology aligned with real operational needs.
Business GoalsRequirementsGap AnalysisVendor SelectionChange ManagementGo Live

01 — Series overview

01Understanding the Problem02Why ERP Projects Fail03Gap Analysis04Business Requirements05Choosing the Right ERP System06Project Planning07Data Migration08System Configuration09Testing & User Acceptance Testing (UAT)10Training & Change Management11Go-Live12Post Go-Live Support
STEP 1 / 12

Understanding the Problemفهم المشكلة

ENGLISH EDITION

ERP implementation success roadmap

The roadmap starts with clear business objectives, documented requirements and a structured gap analysis before any system is selected. It then moves through vendor evaluation, configuration, testing, training and go-live. The message is simple: a successful ERP project is a business transformation supported by technology—not merely a software installation.

English ERP implementation success roadmap by Ahmed Khalf
ARABIC EDITION

خارطة نجاح تطبيق نظام ERP

تقدم النسخة العربية نفس الرحلة بلغة عملية تناسب أصحاب القرار في المنطقة العربية: تبدأ بتحديد الأهداف وتوثيق المتطلبات، ثم تحليل الفجوات واختيار المورد، وصولًا إلى التنفيذ والتشغيل الفعلي. وتوضح كذلك عوامل النجاح الأساسية، مثل توافق أصحاب المصلحة ودقة البيانات وإدارة التغيير والتحسين المستمر.

خارطة نجاح تطبيق نظام ERP بالعربية من إعداد أحمد خلف
STEP 2 / 12

Why ERP Projects Failلماذا تفشل مشاريع ERP

ARABIC EDITION · PART 01

لماذا تفشل بعض مشاريع ERP قبل أن تبدأ؟

يوضح هذا الجزء أن أول أسباب الفشل هو البدء في اختيار النظام قبل فهم طريقة عمل المؤسسة. فغياب الرؤية الواضحة للعمليات يمنع تحديد نقاط الضعف، وأتمتة إجراءات غير سليمة لا تعالج المشكلة بل تجعلها تتكرر بسرعة أكبر. لذلك يبدأ المشروع الناجح بفهم العمليات الحالية وتحديد الاختناقات وتحليل الفجوات ثم تصميم الحل المناسب.

لماذا تفشل بعض مشاريع ERP قبل أن تبدأ — النسخة العربية
ENGLISH EDITION · PART 01

Why Some ERP Projects Fail Before They Begin

This first topic explains why ERP selection should never precede process understanding. When current workflows, bottlenecks and gaps are unclear, the new system may simply automate existing problems. A stronger approach starts with the business, defines what must improve and then selects the ERP solution that best supports those needs.

Why some ERP projects fail before they begin — English edition
STEP 3 / 12

Gap Analysisتحليل الفجوات

ENGLISH EDITION · PART 02

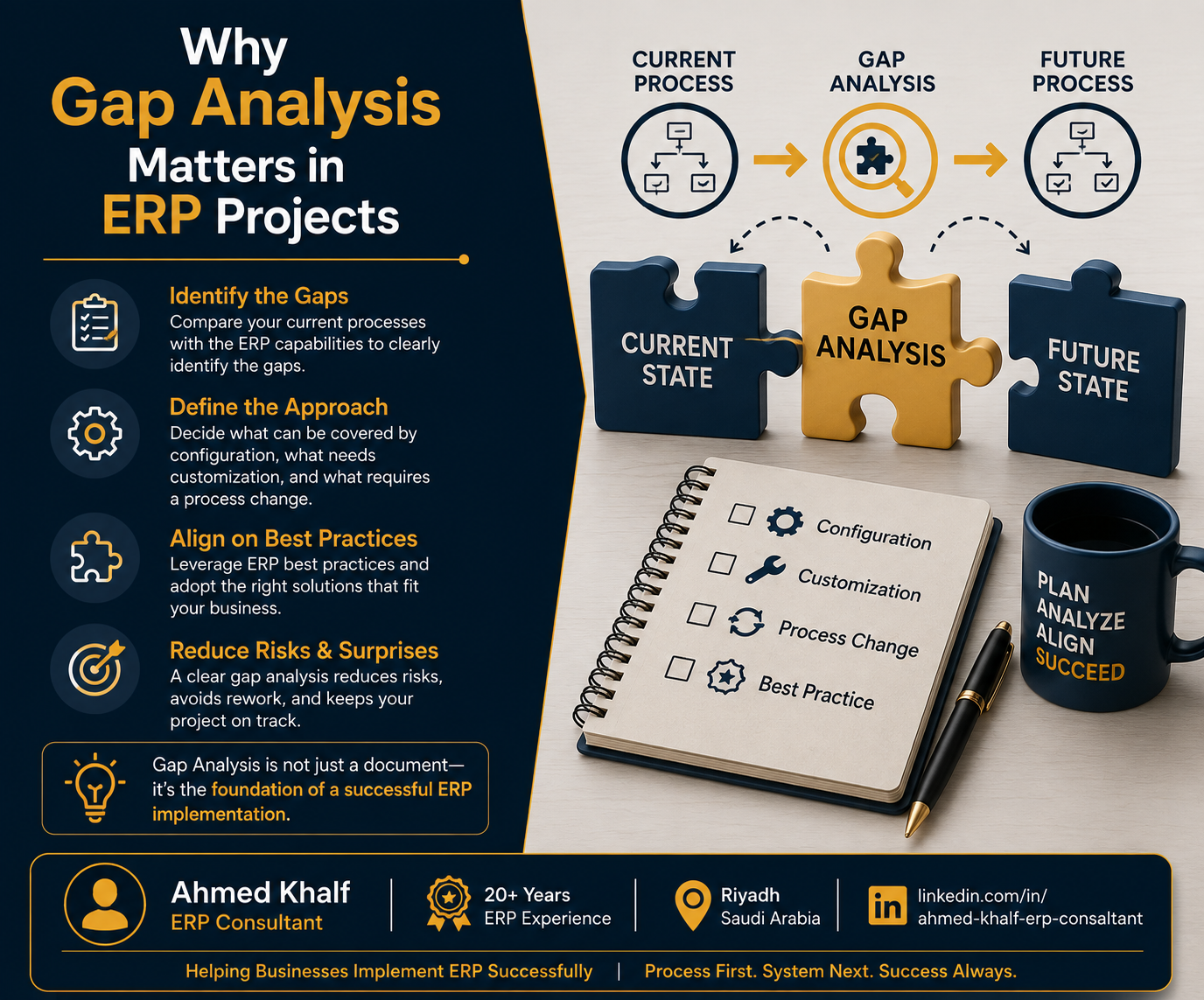

Why Gap Analysis Matters in ERP Projects

Gap analysis connects the current way of working with the future process the organization wants to achieve. It identifies where standard ERP capabilities are sufficient and where configuration, customization or process change is required. Making these decisions early aligns the project with best practices, reduces surprises and prevents costly rework during implementation.

Why gap analysis matters in ERP projects — English edition
ARABIC EDITION · PART 02

لماذا تحليل الفجوات بالغ الأهمية في مشاريع ERP؟

يربط تحليل الفجوات بين الواقع الحالي والعمليات المستقبلية المستهدفة، ويحدد ما يمكن تغطيته بإعدادات النظام القياسية وما يحتاج إلى تخصيص أو تغيير في الإجراء. حسم هذه النقاط مبكرًا يساعد المؤسسة على تبنّي أفضل الممارسات، ويقلل المخاطر والمفاجآت وإعادة العمل أثناء التنفيذ.

أهمية تحليل الفجوات في مشاريع ERP — النسخة العربية
STEP 4 / 12

Business Requirementsمتطلبات العمل

ARABIC EDITION · PART 04

جمع متطلبات العمل: الأساس الحقيقي لنجاح مشروع ERP

تبدأ هذه المرحلة بفهم طريقة تنفيذ العمليات الحالية والتواصل مع أصحاب المصلحة لاكتشاف نقاط الألم والاحتياجات الفعلية. ثم تُوثق المتطلبات الوظيفية وغير الوظيفية، والتقارير ومؤشرات الأداء المطلوبة، والأدوار والصلاحيات ومستويات الوصول. هذا التوثيق يحول احتياجات العمل إلى مرجع واضح لبناء الحل الصحيح وتجنب التعديلات المكلفة لاحقًا.

جمع متطلبات العمل لنجاح مشروع ERP — النسخة العربية
ENGLISH EDITION · PART 04

Business Requirements: The Foundation of ERP Success

Business requirements translate how the organization works into a clear implementation reference. The team documents current workflows, pain points, functional and non-functional needs, reporting expectations, user roles and access controls. Well-defined requirements keep the proposed solution aligned with business priorities, improve user acceptance and reduce costly changes during delivery.

Business requirements as the foundation of ERP success — English edition
STEP 5 / 12

Choosing the Right ERP Systemاختيار نظام ERP المناسب

ENGLISH EDITION · PART 05

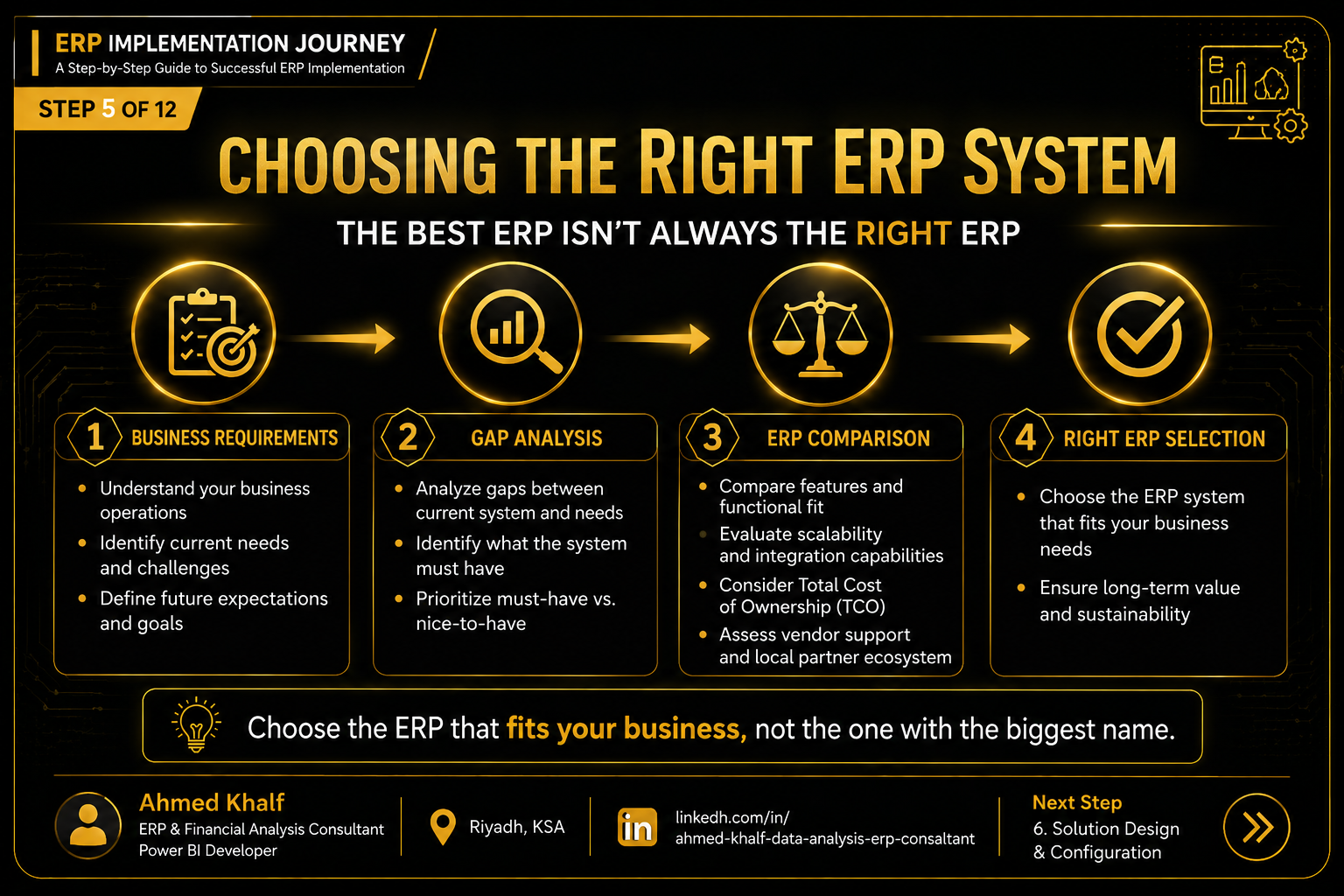

Choosing the Right ERP System

The right ERP is not automatically the largest or most famous product. Selection should begin with business requirements and gap-analysis priorities, then compare functional fit, scalability, integration, total cost of ownership, vendor support and the local partner ecosystem. The best choice is the system that supports today’s operations while remaining sustainable as the organization grows.

Choosing the right ERP system — English edition
ARABIC EDITION · PART 05

اختيار نظام ERP المناسب

لا يعتمد الاختيار الصحيح على شهرة النظام، بل على توافقه مع احتياجات المؤسسة. تبدأ المقارنة بمتطلبات العمل ونتائج تحليل الفجوات، ثم تشمل الملاءمة الوظيفية وقابلية التوسع والتكامل وتكلفة الملكية والدعم ومرونة التخصيص. النظام المناسب هو الذي يخدم العمليات الحالية ويدعم الأهداف المستقبلية ويحقق قيمة طويلة المدى.

اختيار نظام ERP المناسب — النسخة العربية
STEP 6 / 12

Project Planningتخطيط المشروع

BILINGUAL EDITION · PART 06

Project Planning: Turning ERP Strategy into Action

A solid project plan turns ERP strategy into executable work. It defines the project team, scope, deliverables, realistic timeline, milestones, risks and communication plan. Aligning people, processes, technology and data at this stage gives the implementation clear direction, stronger risk control and a better foundation for measurable results.

ERP implementation journey step 6 project planning by Ahmed Khalf
STEP 7 / 12

Data Migrationترحيل البيانات

ERP implementation journey — Step 7: Data Migration — ترحيل البيانات

Data Migration

Data migration establishes a trusted starting point for the new ERP. A successful import is not enough: records must be complete, usable and reconciled to approved source balances.

ERP consultant’s role

The ERP functional consultant agrees the migration scope with business data owners, translates legacy fields into the target structure and coordinates load sequencing with the technical team. Finance and operational owners approve the results; the consultant does not approve business balances on their behalf.

Key activities

  • Profile customers, suppliers, items and accounts; identify missing values, duplicates, obsolete records and inconsistent units or currencies. Assign each cleansing issue to an owner.
  • Approve source-to-target mappings and transformation rules. Load validated master data before opening balances, open receivables/payables and inventory quantities and values.
  • Run repeatable trial migrations. Compare record counts, rejected rows, trial balances, subledger totals and inventory valuation; investigate differences before final sign-off.

Deliverables

Approved mapping workbook, cleansing and exception register, reusable load templates, trial-load evidence, reconciliation pack and signed migration acceptance.

Success factors in practice

Rehearse the final cutover with a defined data freeze and control totals. For example, supplier open items must reconcile to the payable control account, not just match the number of imported rows.

Mistakes to avoid

Avoid migrating every historical record without a business need, silently dropping rejected rows, changing account mappings after approval or allowing duplicate opening balances.

ترحيل البيانات

يؤسس ترحيل البيانات نقطة بداية موثوقة للنظام الجديد. نجاح رفع الملف وحده لا يكفي؛ المطلوب بيانات مكتملة وقابلة للاستخدام وأرصدة مطابقة للمصدر المعتمد.

دور استشاري ERP

يتفق الاستشاري الوظيفي مع ملاك البيانات على نطاق الترحيل، ويربط حقول النظام القديم بهيكل النظام الجديد، وينسق ترتيب التحميل مع الفريق التقني. يعتمد مسؤولو المالية والعمليات النتائج، ولا يحل الاستشاري محلهم في اعتماد الأرصدة.

أهم الأنشطة

  • فحص بيانات العملاء والموردين والأصناف والحسابات، وتحديد النواقص والتكرارات والسجلات غير المستخدمة واختلاف الوحدات والعملات، مع تعيين مسؤول لكل معالجة.
  • اعتماد خريطة الحقول وقواعد التحويل، ثم تحميل البيانات الأساسية قبل الأرصدة الافتتاحية والفواتير المفتوحة وكميات المخزون وقيمته.
  • تنفيذ ترحيلات تجريبية قابلة للتكرار، ومقارنة عدد السجلات والمرفوضات وميزان المراجعة ودفاتر الأستاذ المساعدة وتقييم المخزون، وتحليل الفروق قبل الاعتماد النهائي.

المخرجات

خريطة ربط معتمدة، وسجل تنظيف واستثناءات، وقوالب تحميل، وأدلة الترحيل التجريبي، وملف مطابقة، ومحضر قبول البيانات.

عوامل النجاح والتطبيق العملي

تجربة خطة الترحيل النهائي مع تحديد وقت إيقاف التحديثات ومجاميع الرقابة. مثلًا: يجب أن تطابق فواتير الموردين المفتوحة حساب مراقبة الدائنين، وليس فقط عدد الصفوف المحملة.

أخطاء يجب تجنبها

تجنب نقل كامل التاريخ دون حاجة، أو تجاهل السجلات المرفوضة، أو تغيير الربط بعد اعتماده، أو تحميل الأرصدة الافتتاحية مرتين.

STEP 8 / 12

System Configurationتهيئة النظام

ERP implementation journey — Step 8: System Configuration — تهيئة النظام

System Configuration

Configuration turns approved business requirements into controlled system behavior. Standard features should be evaluated before proposing customization, with each decision traceable to a business requirement.

ERP consultant’s role

The consultant owns functional setup decisions with process owners, documents their accounting and operational impact and coordinates interfaces with technical specialists. Configuration must be reviewed as an integrated solution, not as isolated modules.

Key activities

  • Configure legal entities, fiscal calendars, chart of accounts, cost centers, inventory organizations and module parameters against the approved design.
  • Set role-based access, segregation of duties, approval limits, delegation and escalation paths. Test both permitted and prohibited actions.
  • Configure posting rules, document numbering and cross-module flows. Define interface field mappings, ownership, failure handling and duplicate prevention for external integrations.

Deliverables

Configuration workbook, approved design decisions, access and approval matrices, interface specifications, setup test evidence and a controlled deployment checklist.

Success factors in practice

Trace a purchase from requisition through receipt and supplier invoice to the general ledger. Confirm accounts, cost centers and approval behavior with the owners before freezing the configuration baseline.

Mistakes to avoid

Avoid granting broad administrator access to solve role issues, undocumented production changes, unnecessary customization and integrations without exception monitoring.

تهيئة النظام

تحول تهيئة النظام متطلبات العمل المعتمدة إلى سلوك تشغيلي ورقابي واضح. تُقيّم إمكانات النظام القياسية قبل اقتراح التخصيص، ويرتبط كل قرار باحتياج عمل موثق.

دور استشاري ERP

يقود الاستشاري قرارات الإعداد الوظيفي مع ملاك العمليات، ويوثق أثرها المحاسبي والتشغيلي، وينسق الربط مع المختصين التقنيين. تُراجع التهيئة كحل متكامل، وليس كوحدات منفصلة.

أهم الأنشطة

  • تهيئة الكيانات والفترات المالية ودليل الحسابات ومراكز التكلفة والمخازن ومعاملات الوحدات وفق التصميم المعتمد.
  • إعداد الصلاحيات حسب الأدوار والفصل بين المهام وحدود الموافقة والتفويض والتصعيد، واختبار العمليات المسموح بها والممنوعة.
  • إعداد قواعد القيود وترقيم المستندات وتدفق العمليات بين الوحدات، وتوثيق ربط الحقول ومسؤوليات الواجهات ومعالجة فشل التكامل ومنع التكرار.

المخرجات

دليل إعدادات، وقرارات تصميم معتمدة، ومصفوفة صلاحيات وموافقات، ومواصفات تكامل، وأدلة اختبار، وقائمة نقل إعدادات مضبوطة.

عوامل النجاح والتطبيق العملي

تتبع عملية شراء من الطلب إلى الاستلام وفاتورة المورد ثم الأستاذ العام، والتحقق من الحسابات ومراكز التكلفة والموافقات مع المسؤولين قبل اعتماد خط الأساس للإعدادات.

أخطاء يجب تجنبها

تجنب إعطاء صلاحية المدير لحل كل مشكلة، والتغيير غير الموثق في الإنتاج، والتخصيص غير الضروري، والتكامل دون متابعة للاستثناءات.

STEP 9 / 12

Testing & User Acceptance Testing (UAT)الاختبار وتجربة قبول المستخدم

ERP implementation journey — Step 9: Testing & User Acceptance Testing (UAT) — الاختبار وتجربة قبول المستخدم

Testing & User Acceptance Testing (UAT)

Testing demonstrates that the configured ERP supports real business operations. UAT is the business users’ acceptance of the solution after functional and integration testing, rather than a demonstration by the implementation team.

ERP consultant’s role

The consultant translates requirements into test cases with expected results, prepares representative data and helps key users execute complete workflows. Business process owners decide acceptance based on evidence and agreed exit criteria.

Key activities

  • Build a requirements-to-test matrix covering normal transactions, exceptions, reversals, approval limits and period-end activities. Assign testers and expected outcomes.
  • Execute order-to-cash and procure-to-pay scenarios; verify accounting entries, stock quantities and valuation, interfaces, permissions and financial reports.
  • Log reproducible defects with severity and ownership, fix and retest them, run regression checks and obtain documented user sign-off.

Deliverables

Approved test plan, scenario scripts, traceability matrix, execution evidence, defect and retest register, outstanding-risk decisions and UAT sign-off.

Success factors in practice

For a returned purchase, validate the physical stock reversal, supplier credit and ledger impact together. Resolve blocking defects and obtain explicit acceptance of any residual risks before proceeding.

Mistakes to avoid

Avoid testing only the happy path, letting consultants execute all UAT instead of users, treating attendance as acceptance or closing defects without retest evidence.

الاختبار وتجربة قبول المستخدم

يثبت الاختبار أن النظام المهيأ يدعم العمليات الفعلية. قبول المستخدم يأتي بعد الاختبارات الوظيفية والتكاملية، وهو قبول أصحاب العمل للحل، وليس مجرد عرض يقدمه فريق التنفيذ.

دور استشاري ERP

يحوّل الاستشاري المتطلبات إلى حالات اختبار ذات نتائج متوقعة، ويجهز بيانات ممثلة للواقع، ويدعم المستخدمين الرئيسيين في تنفيذ الدورة كاملة. يقرر ملاك العمليات القبول استنادًا إلى الأدلة ومعايير الخروج المتفق عليها.

أهم الأنشطة

  • إعداد مصفوفة تربط المتطلبات بالاختبارات، وتشمل الحالات المعتادة والاستثناءات والعكس وحدود الموافقة والإقفال، مع تحديد المنفذين والنتائج المتوقعة.
  • اختبار دورات البيع والتحصيل والشراء والسداد، ومراجعة القيود المحاسبية وحركة المخزون وتقييمه والواجهات والصلاحيات والتقارير المالية.
  • تسجيل المشكلات بخطوات إعادة إنتاجها وأولويتها ومسؤولها، ثم الإصلاح وإعادة الاختبار واختبارات عدم التأثير والحصول على اعتماد موثق من المستخدمين.

المخرجات

خطة اختبار معتمدة، وسيناريوهات، ومصفوفة تتبع، وأدلة تنفيذ، وسجل مشكلات وإعادة اختبار، وقرارات المخاطر المتبقية، ومحضر قبول المستخدم.

عوامل النجاح والتطبيق العملي

في مرتجع المشتريات، تُراجع حركة المخزون وإشعار المورد وأثر الأستاذ العام معًا. تُغلق المشكلات المانعة، وتُعتمد المخاطر المتبقية صراحة قبل الانتقال للتشغيل.

أخطاء يجب تجنبها

تجنب اختبار الحالات السهلة فقط، أو تنفيذ الاستشاري لكل اختبارات القبول بدل المستخدمين، أو اعتبار حضور التدريب قبولًا، أو إغلاق المشكلة دون دليل إعادة اختبار.

STEP 10 / 12

Training & Change Managementالتدريب وإدارة التغيير

ERP implementation journey — Step 10: Training & Change Management — التدريب وإدارة التغيير

Training & Change Management

Training and change management make the new process usable in everyday work. Readiness depends on whether users can perform their own tasks and handle exceptions, not simply on attendance at a presentation.

ERP consultant’s role

The consultant works with managers and key users to identify role-specific learning needs, explain process changes and build a support network. Sponsors own change adoption; the consultant provides practical tools, coaching and evidence of readiness.

Key activities

  • Map user roles to tasks and prepare a training schedule, task guides, quick references and realistic practice exercises.
  • Train in a dedicated environment with representative, appropriately protected data. Let each user complete transactions, approvals and corrections independently.
  • Capture concerns and resistance, explain changes in responsibilities, coach change champions and assess task completion before go-live.

Deliverables

Role-based training matrix, bilingual guides where needed, exercise data, attendance and competency records, communication plan and readiness gap/action register.

Success factors in practice

Ask an accounts-payable user to enter an invoice, resolve a mismatch and send it for approval without instructor intervention. Arrange targeted retraining and confirm access for each role.

Mistakes to avoid

Avoid generic one-off demonstrations, using live production transactions for practice, last-minute training and assuming that low complaint volume means successful adoption.

التدريب وإدارة التغيير

يجعل التدريب وإدارة التغيير العمليات الجديدة قابلة للتنفيذ يوميًا. تُقاس الجاهزية بقدرة المستخدم على أداء مهامه ومعالجة الاستثناءات، وليس بمجرد حضور عرض تدريبي.

دور استشاري ERP

يعمل الاستشاري مع المديرين والمستخدمين الرئيسيين لتحديد احتياجات التدريب حسب الدور وشرح تغير الإجراءات وبناء شبكة دعم. تتولى الإدارة مسؤولية تبني التغيير، ويوفر الاستشاري الأدوات والتوجيه وأدلة الجاهزية.

أهم الأنشطة

  • ربط الأدوار بالمهام وإعداد جدول تدريب وأدلة عمل ومراجع سريعة وتمارين عملية ممثلة للواقع.
  • التدريب في بيئة مخصصة ببيانات مناسبة ومحمية، مع تنفيذ كل مستخدم للعمليات والموافقات والتصحيحات بنفسه.
  • جمع أسباب المقاومة والمخاوف وشرح تغير المسؤوليات وتدريب داعمي التغيير، ثم تقييم إنجاز المهام قبل التشغيل.

المخرجات

مصفوفة تدريب حسب الأدوار، وأدلة باللغات المطلوبة، وبيانات تمارين، وسجلات حضور وكفاءة، وخطة تواصل، وسجل فجوات جاهزية وإجراءات معالجة.

عوامل النجاح والتطبيق العملي

تكليف مستخدم الدائنين بإدخال فاتورة ومعالجة اختلاف وإرسالها للاعتماد دون تدخل المدرب، ثم إعادة التدريب بشكل موجه والتأكد من صلاحية وصول كل دور.

أخطاء يجب تجنبها

تجنب الاكتفاء بعرض عام واحد، أو التدريب بمعاملات فعلية في الإنتاج، أو تأجيل التدريب لآخر لحظة، أو اعتبار قلة الشكاوى دليلًا على التبني.

STEP 11 / 12

Go-Liveالتشغيل الفعلي

ERP implementation journey — Step 11: Go-Live — التشغيل الفعلي

Go-Live

Go-live is a controlled transition from the legacy process to daily operation on the new ERP. The decision should follow agreed readiness criteria, a rehearsed cutover plan and clear accountability.

ERP consultant’s role

The consultant coordinates functional readiness, validates final balances and supports the go/no-go review. The authorized business sponsor makes the decision, while technical teams manage deployment, backups and recovery arrangements.

Key activities

  • Confirm UAT acceptance, user readiness, access, integrations, support coverage and a timed cutover checklist with owners and dependencies.
  • Freeze legacy updates as planned, load final or delta data, reconcile balances and obtain approval before opening access to business transactions.
  • Monitor first orders, receipts, invoices, payments and postings. Triage issues through a command center with daily status updates and escalation routes.

Deliverables

Approved go/no-go record, executed cutover checklist, final reconciliation, agreed rollback/continuity plan, support rota and daily stabilization issue log.

Success factors in practice

Define decision deadlines and rollback triggers before cutover, including how transactions already entered in the new system would be handled. Track critical business transactions through to reports during the first days.

Mistakes to avoid

Avoid launching with unresolved blocking issues, simultaneous uncontrolled posting in both systems, changes outside the cutover plan and declaring success merely because users can log in.

التشغيل الفعلي

التشغيل الفعلي انتقال منضبط من النظام القديم إلى العمل اليومي على النظام الجديد، بناءً على معايير جاهزية متفق عليها وخطة انتقال مجربة ومسؤوليات واضحة.

دور استشاري ERP

ينسق الاستشاري الجاهزية الوظيفية ويتحقق من الأرصدة النهائية ويدعم قرار التشغيل أو التأجيل. يصدر القرار صاحب الصلاحية في الأعمال، وتتولى الفرق التقنية النشر والنسخ الاحتياطي وترتيبات الاستعادة.

أهم الأنشطة

  • التأكد من قبول الاختبارات وجاهزية المستخدمين والصلاحيات والتكامل وتغطية الدعم، واعتماد قائمة انتقال زمنية تحدد المسؤولين والاعتماديات.
  • إيقاف تحديثات المصدر حسب الخطة وتحميل البيانات النهائية أو الفروق، ومطابقة الأرصدة واعتمادها قبل إتاحة تسجيل المعاملات.
  • متابعة أول الطلبات والاستلامات والفواتير والمدفوعات والقيود، وفرز المشكلات من خلال فريق دعم مركزي بتحديثات يومية ومسارات تصعيد.

المخرجات

محضر قرار التشغيل، وقائمة انتقال منفذة، ومطابقة نهائية، وخطة رجوع واستمرارية متفق عليها، وجدول دعم، وسجل متابعة يومي للاستقرار.

عوامل النجاح والتطبيق العملي

تحديد مواعيد القرار وشروط الرجوع مسبقًا، بما يشمل التعامل مع المعاملات التي سُجلت بالفعل في النظام الجديد، وتتبع العمليات الحرجة حتى التقارير خلال الأيام الأولى.

أخطاء يجب تجنبها

تجنب التشغيل مع مشكلات مانعة، أو التسجيل غير المنضبط في النظامين معًا، أو تغييرات خارج خطة الانتقال، أو اعتبار نجاح تسجيل الدخول نجاحًا للتشغيل.

STEP 12 / 12

Post Go-Live Supportالدعم بعد التشغيل

ERP implementation journey — Step 12: Post Go-Live Support — الدعم بعد التشغيل

Post Go-Live Support

Post go-live support protects operational stability and turns the implementation into sustained business value. Intensive early support should transition to an agreed service model with ownership and measurable improvement goals.

ERP consultant’s role

The functional consultant investigates process and posting issues, coordinates technical fixes, coaches users and supports the first financial close. Together with process owners, the consultant separates incidents from enhancement requests and prioritizes the improvement backlog.

Key activities

  • Operate a support queue with severity, response targets, escalation and ownership. Document root causes and reusable resolutions.
  • Monitor integrations, failed jobs, reconciliation exceptions, system performance and access. Test fixes and updates before controlled release.
  • Improve reports and procedures through approved changes. Compare baseline and post-launch measures such as closing time, error rates, inventory accuracy and user adoption.

Deliverables

Support handover and service model, issue and root-cause register, knowledge base, first-close checklist, prioritized enhancements and benefits review.

Success factors in practice

Agree measurable exit criteria for intensive support and review recurring incidents. Validate report totals against the ledger and assess benefits over an appropriate period rather than relying on dashboard activity alone.

Mistakes to avoid

Avoid undocumented fixes directly in production, treating every request as an emergency, measuring only system uptime or ending support before business owners can operate independently.

الدعم بعد التشغيل

يحافظ الدعم بعد التشغيل على استقرار العمليات ويحوّل التنفيذ إلى قيمة مستمرة. تنتقل فترة الدعم المكثف إلى نموذج خدمة واضح المسؤوليات وأهداف تحسين قابلة للقياس.

دور استشاري ERP

يحلل الاستشاري المشكلات الوظيفية والقيود وينسق الحلول التقنية ويوجه المستخدمين ويدعم أول إقفال مالي. ويفصل مع ملاك العمليات بين الأعطال وطلبات التطوير لترتيب قائمة التحسينات.

أهم الأنشطة

  • إدارة سجل دعم يحدد الأولوية وزمن الاستجابة والتصعيد والمسؤولية، وتوثيق الأسباب الجذرية والحلول القابلة لإعادة الاستخدام.
  • متابعة التكامل والمهام المتعثرة وفروق المطابقة والأداء والصلاحيات، واختبار الإصلاحات والتحديثات قبل إصدارها بشكل منضبط.
  • تطوير التقارير والإجراءات عبر تغييرات معتمدة، ومقارنة مؤشرات ما قبل التشغيل وبعده مثل زمن الإقفال والأخطاء ودقة المخزون وتبني المستخدمين.

المخرجات

محضر تسليم الدعم ونموذج الخدمة، وسجل مشكلات وأسباب جذرية، وقاعدة معرفة، وقائمة أول إقفال، وخطة تحسين مرتبة، ومراجعة للفوائد المحققة.

عوامل النجاح والتطبيق العملي

تحديد معايير قابلة للقياس لإنهاء الدعم المكثف ومراجعة المشكلات المتكررة، ومطابقة التقارير مع الأستاذ العام وقياس الفوائد خلال فترة مناسبة بدل الاكتفاء بعدد مرات فتح اللوحات.

أخطاء يجب تجنبها

تجنب الإصلاحات غير الموثقة في الإنتاج، أو اعتبار كل طلب حالة طارئة، أو قياس نجاح النظام بتوافره فقط، أو إنهاء الدعم قبل استقلال ملاك العمليات.

02 — ERP SUCCESS

A practical guide for better ERP decisions

These 12 stages connect business understanding with implementation, user acceptance and sustained operational value. Use the activities and deliverables as a practical starting point, adapting responsibilities and acceptance criteria to the project scope.
